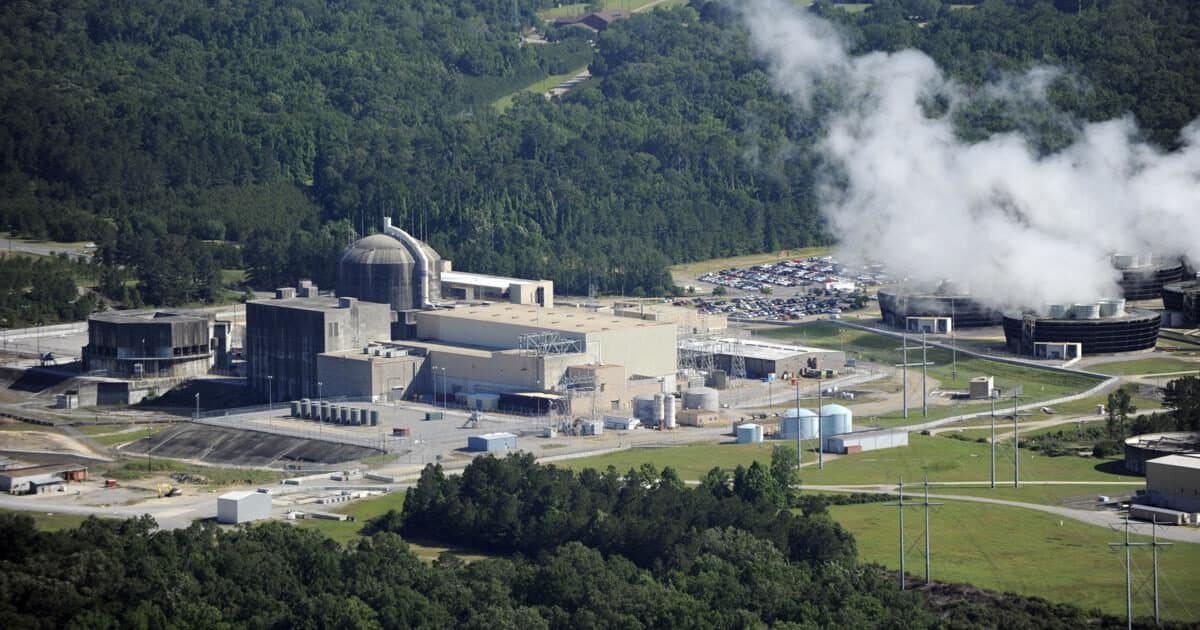

On the Mississippi near Killona, a reactor at 75 percent power tripped on October 16, hours before its scheduled shutdown, and a backup bus transfer failed too
Floodlights cut through the dark over a wide stretch of river water.
Inside the plant, alarms start stacking on a control panel nobody expected to light up that night.
A crew that had spent weeks preparing for a calm, scheduled descent suddenly has seconds to react instead.
Inspectors from the Nuclear Regulatory Commission’s Region 4 office will review the bus transfer failure alongside the routine outage work already underway.
Diesel engines roar to life in a building built for exactly this moment.
So what actually happens inside a reactor when a routine turbine check spirals into an automatic shutdown?
What makes a turbine test turn into a full reactor trip
A pressurized water reactor does not run its turbine and its core as separate machines that can be adjusted independently once the unit is at power. The turbine and core stay tightly coupled, so when operators tested the turbine’s governor valves and the turbine tripped, the reactor followed within seconds, with every control rod driving into the core.
That part of the sequence is unremarkable, since turbine trips at pressurized water reactors routinely cascade into reactor trips. The safety systems are built around that exact outcome.
But what happened next was not supposed to happen at all. Entergy told the Nuclear Regulatory Commission that the fast dead bus transfer of the plant’s 2B electrical bus failed during the trip sequence, a gap a sensitive safety system is designed never to show.
So the plant’s backstop kicked in instead. Emergency diesel generator B started on its own and picked up the 3B bus, exactly the kind of automatic backup response the design expects when a primary transfer does not land, and the unit also received an emergency feedwater actuation signal.
A ceremony that never happened on the Mississippi
A refueling outage is the most scheduled event in a nuclear plant’s calendar. The date is fixed a year or more in advance, and hundreds of contractors book into every motel within an hour’s drive, while replacement fuel assemblies arrive on trucks weeks ahead of time.
Waterford 3’s outage had been lined up for the morning of October 17, with a gradual power descent planned for the 1,152 megawatt reactor. The plan called for operators to ease the unit down over several hours, the usual unhurried glide that lets every system settle before the core comes open.
Instead, at 10:45 p.m. the night before, with the reactor at 75 percent power, the turbine test tripped the unit outright. The outage still happened, just without the ceremony.
Five days later the unit sat at zero percent power in the Nuclear Regulatory Commission’s daily status report, already well into the outage it had been scheduled for anyway.
What the event report actually documents
The plant’s account reached federal regulators within hours, logged as Event Number 58501 in the agency’s event notification report. Entergy told the NRC that “Fast dead bus transfer of the ‘B’ bus failed,” and that emergency diesel generator B started on its own and picked up the 3B bus.
The plant also got an emergency feedwater actuation signal. This is the category of filing the industry calls a four hour notification, meaning Entergy judged it serious enough to report quickly but not an emergency.
Because the reactor was already descending toward its refueling shutdown, the turbine trip simply arrived ahead of schedule rather than out of nowhere. Entergy said the cause of the turbine trip itself remains under investigation, leaving two open threads rather than one.
The agency’s power reactor status report for October 23, 2026 still lists Waterford 3 at zero percent, well into the outage.
Why a backup that caught itself still matters
None of this looks like a near miss in the dramatic sense. The emergency diesel did exactly what it is built to do, and it did it within the window the plant’s safety case assumes.
A similar logic played out earlier this year when a Texas reactor tripped and leaned on backup equipment that was not fully available. Yet a failed fast bus transfer is not nothing, since these transfers exist precisely because operators cannot count on manual intervention in the half second after a trip.
When one does not complete, the plant is relying on its second line of defense on the very night that defense gets tested for real, not in a drill. The diesel started, the bus picked up power, and the plant reached stable shutdown conditions without further complication.
What comes next for the plant and the investigation
Waterford 3 remains in its refueling outage, the same one that had been on the calendar for over a year, just triggered a few hours early and by different means. Inspectors from the Nuclear Regulatory Commission’s Region 4 office will review the bus transfer failure alongside the routine outage work already underway.
The open question is whether the failed transfer points to a recurring component problem, the kind of finding that in other cases has pushed plants toward broader fixes, such as the fuel chain work tracked at an enrichment plant expanding capacity elsewhere in the supply chain.
For now, Entergy has not said whether the 2B bus transfer has a known history of similar trouble. Even so, the plant’s layered defenses did their job in the order they were meant to, even if the first layer skipped its line.
The refueling outage will proceed as scheduled, just a few hours ahead of plan, and the investigation into what tripped the turbine will decide whether this was an isolated stumble or something the plant needs to rebuild around.
